What if you could predict delays before they even happen? Not after a deadline slips or a client chases an update, but before your team even realizes there is a risk. Imagine knowing exactly which tasks could push your project off track and stopping the problem before it even begins. Sounds like a game changer, doesn't it?
In many projects, delays aren’t caused by a lack of effort. They usually start with a single overlooked task that leads to missed deadlines. But what if you had a way to spot them early and plan accordingly? That's where the Critical Path Method in Project Management comes as a savior for many. In this blog, you’ll learn what CPM is, how it works, its importance, and how to build one alongside tools like PERT and Gantt charts. Let's dive in!
The Critical Path Method (CPM) is a Project Management technique used to plan, schedule, and control project activities. It helps teams identify the longest sequence of tasks that directly affect the project completion date. CPM is widely used across industries to manage complex projects with multiple dependencies and timelines.
In CPM, tasks are classified as critical or non-critical. Critical tasks must be completed on time, as any delay will impact the overall project schedule. Non-critical tasks have some scheduling flexibility without affecting the final deadline. By identifying the Critical Path, Project Managers can prioritize work, allocate resources effectively, reduce risks, and keep projects on track.
The Critical Path Method (CPM) helps improve project planning by comparing schedules with actual progress and identifying the tasks that have the greatest impact on delivery. It supports better resource allocation, prevents bottlenecks, clarifies task sequences, and enables more accurate scheduling. By highlighting critical activities and potential risks, CPM helps Project Managers make informed decisions, maintain project momentum, and improve the likelihood of completing projects on time.

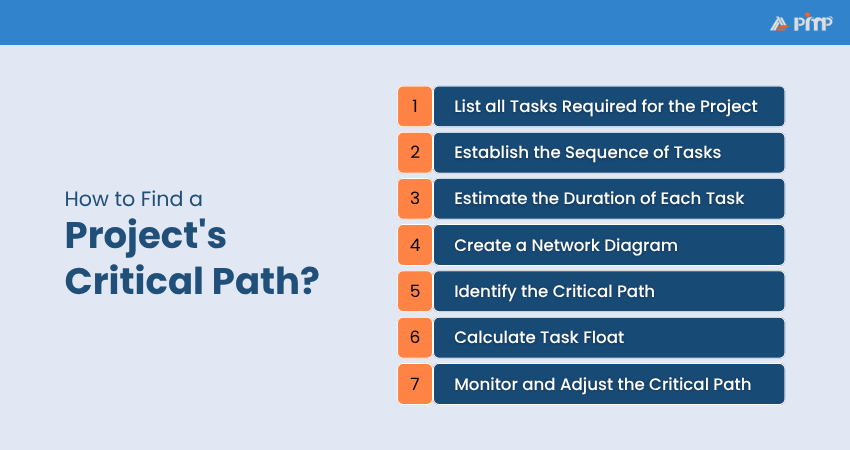

Identifying the Critical Path is a structured process that involves some essential steps. Here's how to do it:

Start by dividing the project into individual tasks. Later, you need to write down every task needed to finish the project. This can be done using a Work Breakdown Structure (WBS) or a task list. Each task should be small and clear, with a specific goal.
Next, you need to find the order in which the tasks should happen. Some tasks can be done at the same time, while others need to wait until previous ones are finished. This step is about spotting dependencies. Understanding this helps you build a solid project timeline.
For example:
1) Task D can’t start until Task A is finished
2) Tasks A and B might run at the same time
3) Task E may depend on D, and Task F might follow E
Now, you need to fix a time for how long a task will take to complete from start to finish. It is important to be realistic and, if needed, include buffer time for possible delays. To plan accurately, you can use these two techniques:
1) Forward Pass: Start from the beginning of the project and move forward. This helps calculate the earliest start and finish times for each task.
2) Backward Pass: Work backward from the end of the project to find the latest start and finish times.
These two calculations help you identify which tasks are critical and how much flexibility others have.

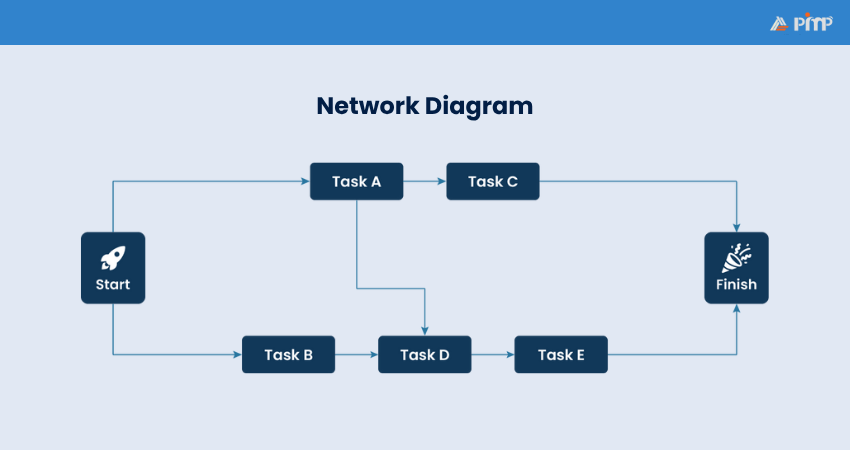

A network diagram, also known as a project logic diagram, is a visual map of the sequence of tasks and their dependencies. Each task is shown as a box (node), and arrows between them show dependencies. There are two common types of diagrams:
1) Activity-on-Node (AON): Tasks are represented as nodes.
2) Activity-on-Arrow (AOA):
Tasks are represented on the arrows, with events as nodes.
Advance to the next level of leadership with our
Program Management Professional (PgMP)® Certification Training– Register today!
Now that your network is set up, it is time to find the Critical Path, which is the longest sequence of dependent tasks from the start to the end of the project. These are the tasks that:
1) Must be completed on time
2) Have no float (flexibility)
3) Directly affects your project’s finish date
For example, if Tasks A → D → E → F take 10 days and that is the longest route through your project, then that will be your Critical Path.
Float, also called slack, is the amount of time a task can be delayed without affecting the end date of the project. Tasks on the Critical Path have zero float, meaning they can’t be delayed at all. But tasks not on the Critical Path might have some flexibility.
1) Total Float: How much a task can be delayed without delaying the whole project.
2) Free Float:
How much a task can be delayed by not delaying the start of the next task.
Once the project starts, keep a close eye on the Critical Path. If any tasks are delayed, the entire project could be at risk. Using tools or software like Microsoft Project can make tracking easier. They help update your schedule, calculate float automatically, and keep the project moving smoothly. Meanwhile, you can:
1) Update the timeline regularly
2) Check task progress
3) Recalculate the Critical Path if anything changes
Applying the Critical Path Method in Project Management involves more than identifying critical activities. Project Managers must actively manage schedules, optimize resources, and monitor project performance to keep the project on track. The following practices help maximize the effectiveness of CPM throughout the project lifecycle:
Schedule compression helps reduce project duration without changing the project scope. By identifying critical activities, Project Managers can focus on accelerating tasks that directly affect the project's completion date. Techniques such as crashing (adding resources to critical tasks) and fast-tracking (performing certain activities in parallel) can help reduce the overall project duration without compromising key objectives.
CPM in Project Management assists in managing limited resources by highlighting which activities are critical and which have scheduling flexibility. Project Managers can reassign resources from non-critical tasks with available float to critical activities that require additional support. This helps optimize resource utilization and maintain workflow continuity while reducing the risk of project delays.
Tracking project performance data is essential for improving future planning and estimation. Key information such as task durations, dependencies, resource utilization, Critical Path changes, and cost performance provides valuable insights. Over time, this data helps organizations create more accurate schedules, allocate resources efficiently, and make better project decisions.
Here are some of the benefits of using Critical Path Method in Project Management:
Once you know which tasks are on the Critical Path, you know which ones are most important. This helps you focus on what really matters, the tasks that must be finished on time to keep the project moving. Even if other small tasks are delayed, these key tasks stay on track. It helps:
1) Focus on tasks that directly affect project deadlines
2) Lead quick decisions during delays or issues
3) Ensure efficient use of resources on high-priority tasks
If you use CPM with Program Evaluation and Review Technique (PERT) charts, you can build a more realistic schedule. PERT helps you guess task durations more carefully by looking at best-case, worst-case, and average time estimates. This helps you:
1) Plan better
2) Spot risky tasks early
3) Avoid last-minute delays
When you combine CPM with a Gantt chart, you get a simple timeline view of your project. These visuals are great for team members and clients who prefer to see the schedule visually. It is helpful during project reviews or when presenting updates to stakeholders. It shows:
1) When tasks start and end
2) Which tasks can happen at the same time
3) What needs to be done next
CPM shows everyone what tasks need to be done and when. This makes it easier for everyone on the team to stay on the same page, from team members to stakeholders, managers, and clients. It aims to:
1) Improve clarity around responsibilities and deadlines
2) Reduce confusion and miscommunication
3) Keep stakeholders informed and engaged
Gain real-world Project Management knowledge with our
PMI Project Management Ready® Certification Training – Join now!
While the Critical Path Method in Project Management is useful for planning, it has some limitations. Those include:
1) Needs Accurate Data: If task times or dependencies are wrong, then the Critical Path and your schedule will be unreliable.
2) Not Very Flexible: In fast-moving or Agile projects, CPM can be too rigid and slow to update.
3) Overlooks Non-critical Tasks: It focuses on critical tasks, but ignoring smaller tasks can still cause quality or team issues.
4) Doesn’t Track Resources: CPM doesn’t show if people are overbooked or working on multiple tasks at once, which can cause delays.
CPM works best with stable, well-planned projects and should be combined with tools that handle changes and resource planning better.

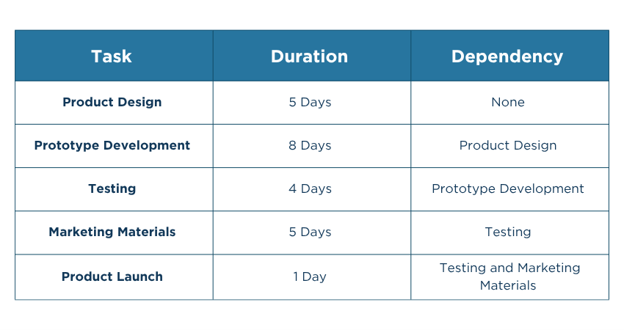

Consider a company launching a new product. The project includes activities such as market research, product design, prototype development, testing, marketing preparation, and product launch. Some tasks can only begin after others are completed. For example, testing cannot start until the prototype is ready, and the launch cannot take place until testing and marketing activities are complete. CPM helps map these dependencies and identify the longest sequence of tasks that directly determine the project completion date.
In this scenario, the Critical Path might be: Product Design → Prototype Development → Testing and Marketing Materials → Product Launch. Since these activities are critical, a delay in any one of them will delay the entire project. Other activities, such as preparing promotional materials, may have some scheduling flexibility and are therefore considered non-critical. By identifying the critical path, Project Managers can prioritize key tasks, allocate resources effectively, and minimize the risk of missing project deadlines.

This example demonstrates how CPM helps Project Managers identify the activities that have the greatest impact on project delivery. By focusing on critical tasks and monitoring their progress closely, teams can make informed decisions, manage resources more effectively, and respond quickly to potential delays.

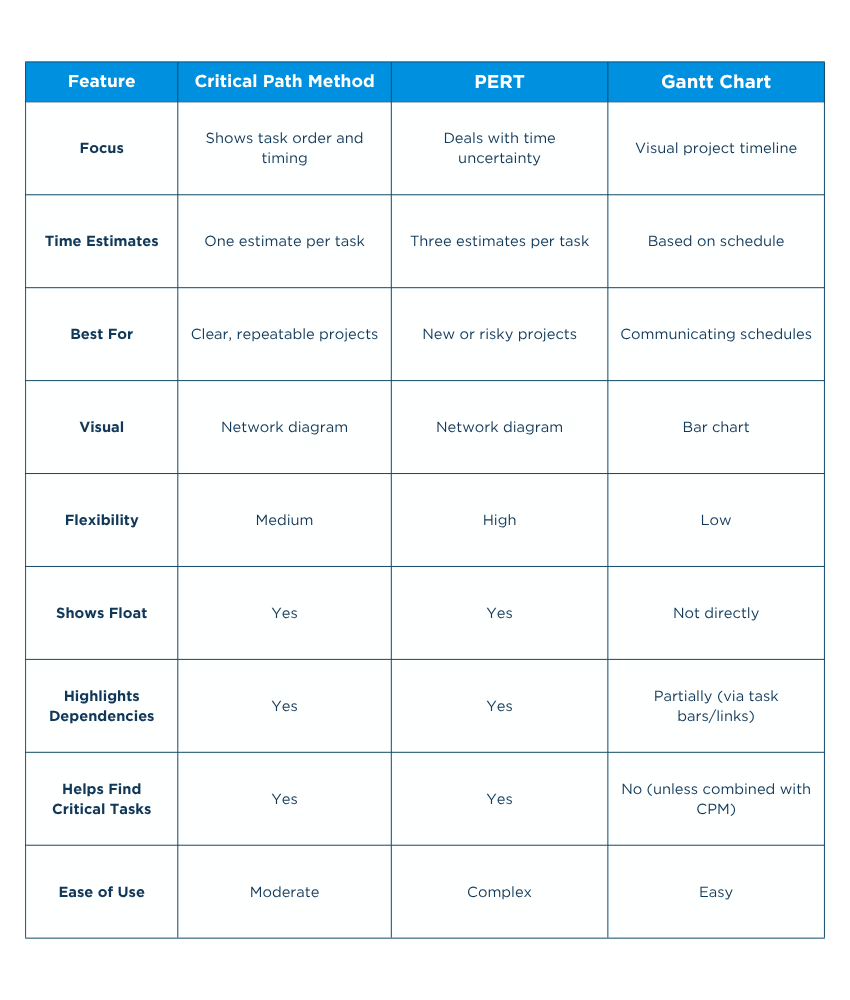

Here’s a simple comparison of the Critical Path Method vs PERT vs Gantt Charts:

The CPM, PERT, and Gantt Charts are all valuable Project Management tools, but they serve different purposes. CPM focuses on identifying the sequence of critical tasks that determines the project's completion date, making it ideal for planning and schedule control.
PERT is designed for projects with uncertain activity durations and uses multiple time estimates to improve forecasting. In contrast, Gantt Charts provide a visual timeline of tasks, helping teams track progress and communicate schedules effectively. While CPM and PERT emphasize task dependencies and critical activities, Gantt Charts are primarily used for project monitoring and reporting.
The Critical Path Method in Project Management is one of the most effective tools for planning, scheduling, and staying on track. By focusing on this path, you can stay in control and deal with problems before they cause major delays. If you want your project to finish on time and with fewer surprises, understanding and applying CPM is a smart move.
Boost your Project Management career with our Project Management Institute (PMI)® Certification Training – Lead with confidence and success!
CPM helps you find the most important tasks that must be done on time to finish a project. PERT is similar, but it uses three time estimates per task to deal with uncertainty. CPM works well for known tasks; PERT is better when task times are unclear.
The Critical Path should be reviewed and updated regularly throughout the project lifecycle, especially when tasks are completed, delayed, added, or changed. Frequent updates help identify schedule risks early, maintain accurate timelines, and ensure resources remain focused on activities that affect project completion.
